FY26 Water Line Replacement Project

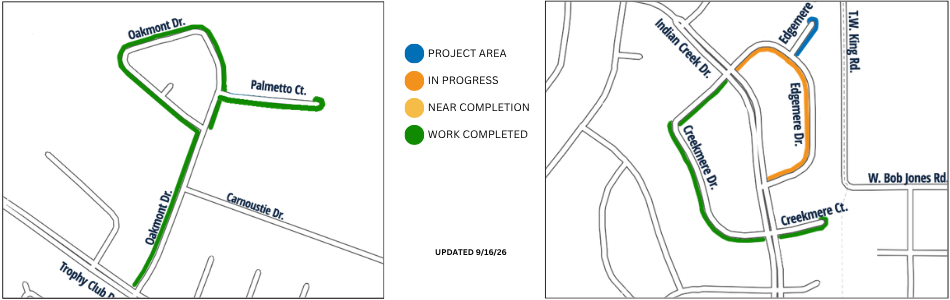

Maps showing streets within the FY26 Water Line Replacement Project. Streets completed: Palmetto Ct, Oakmont Dr, Creekmere Dr. Streets in progress: Creekmere Ct, Edgemere Dr. Upcoming streets:  Edgemere Ct.
Updated 9/16/26

Estimated Timeline

  • Oakmont Dr: mid-May - June
  • Creekmere Dr: August - September
  • Edgemere Dr/Ct and Creekmere Ct: September - October

Scope of Work

This water line project will replace approximately 6,300 linear feet of the existing water lines with new high pressure polyvinyl chloride (PVC) pipe. PVC is not susceptible to alkaline or acid soil conditions and can bend without breaking to accommodate minor movement in our Texas soil.

Schedule

  • The project kicked off at the beginning of May.
  • Normal work hours are Monday through Friday from 7:00 a.m. – 7:00 p.m.
  • We anticipate this project taking approximately five months to complete.
  • Dates may change due to widespread rain, freezing temperatures, equipment failures, material delays or other unforeseen circumstances.

What To Expect

A temporary water line will be set up that will provide water to homes during construction. There will be minor interruptions to your water service when it is connected and disconnected. You will be notified 48 hours in advance of the work. You can expect minor traffic impacts, rolling shoulder closures and periodic intersection closures.

Project Contacts

Rob Vaughn Mike McMahon
Trinity Miller Utility & Construction Operations Manager
rob.vaughn@trinitymillerllc.com mmcmahon@tcmud.org
817-709-6540 682-831-4689



Trophy Club Utility Service Contacts

While we strive to avoid interruptions, construction activities may occasionally affect your utility services. If you experience a service outage, please contact the appropriate provider below:

Electricity/Streetlights
Oncor 888-313-4747
Oncor Streetlights https://www.oncorstreetlight.com/
Cable/Fiber/Internet
AT&T 800-288-2020
Fiber First 833-342-7444
One Source/Ubiquity 843-497-6485
Spectrum 833-267-6094
Natural Gas
Atmos Energy 866-322-8667

Monthly Email Updates

Regular updates about the project can be found here.

Join our mailing list
